How Atlas Built a 1,274-Pallet Returnable Program for a Major Robotics Installer in Four Months

A heavy-duty 104 by 96 inch returnable pallet program that scaled from zero to 1,274 units between January and May 2026. The biggest custom build in Atlas's history.

CUSTOMER · A major robotics installation customer PROGRAM · 104 by 96 returnable pallet RUNNING SINCE · January 2026

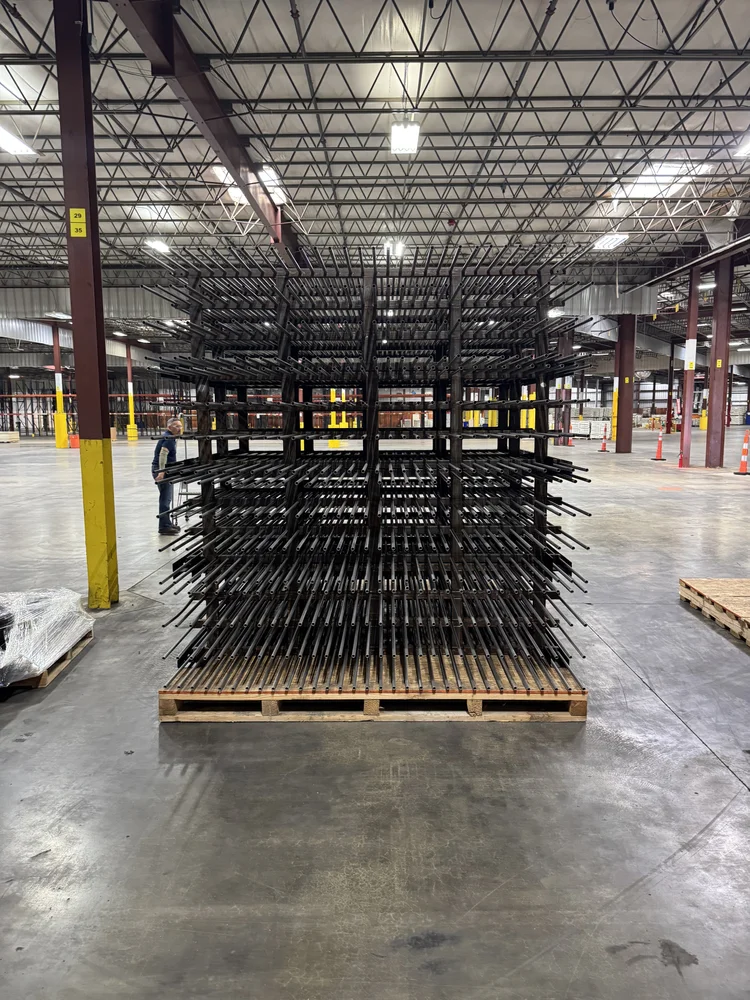

An Atlas custom pallet loaded with equipment at a customer's loading dock

The challenge

The customer builds the automated warehouse hardware that runs the largest distribution centers in retail. The racks load floor-to-ceiling. The drives and support structures carry serious weight. None of it fits a 48 by 40 GMA pallet.

Every install starts the same way. The pallet carries the equipment from the manufacturing site, rides a truck for a long haul, and sits on a busy install floor while crews stage the rack rows. Then it goes back for the next install. A pallet failure on a program like this is not a paperwork problem. It is a hot mess.

The first time the customer asked Atlas to quote the build, it wasn't even clear what was going to be needed to ship their metal racking. The racking was pre-assembled modular units that install rapidly, but present all sorts of problems in shipping. The units are bulky, heavy, and delicate. Just the situation where careful packaging is required.

The initial packing plan the customer was using could get 24 units onto a flatbed trailer. With an average of 25,000 units per installation site, they were looking for better options.

The solution

By reconfiguring the pallet and rearranging the placement of the units, we developed a system where they could get 72 units per truckload, and could use regular 53 foot dry vans.

The throughput story

Units per truckload, before and after Atlas's pallet redesign.

24 Original packing plan on a flatbed trailer 72 Atlas redesign on a standard 53 foot dry van 3x throughput

695 fewer trucks per installation. An average install site needs 25,000 units. The original packing plan took 1,042 trucks. The Atlas redesign takes 347.

Several different methods of securing the loads to the pallet were tested out, many requiring revisions to the pallet specs. The design process is inevitably messy. Another idea for added stability, yet another CAD, build the sample, test it out. This brings up some questions and another idea, and the cycle repeats.

15 iterations before the first truckload

The design-and-feedback cycle Atlas ran with the customer's engineers.

15 DESIGN ITERATIONS Idea or feedback from engineering review CAD update spec revised Build sample prototype to spec Test under load review with customer

Version 15 shipped in January 2026. The first truckload of many. Atlas stayed with the program through every revision because the goal was to ship the spec right, not ship the spec fast.

Atlas worked with the customer's engineers, and version 15 of the pallet shipped in January 2026. The first truckload of many.

The full deck had to support a footprint larger than a standard pallet, with no overhang and no flex under load. The heat treatment had to meet ISPM-15 for the cross-border leg, which means 133 degrees Fahrenheit for 30 minutes, the IPPC stamp on every pallet, and the export paperwork on every truck.

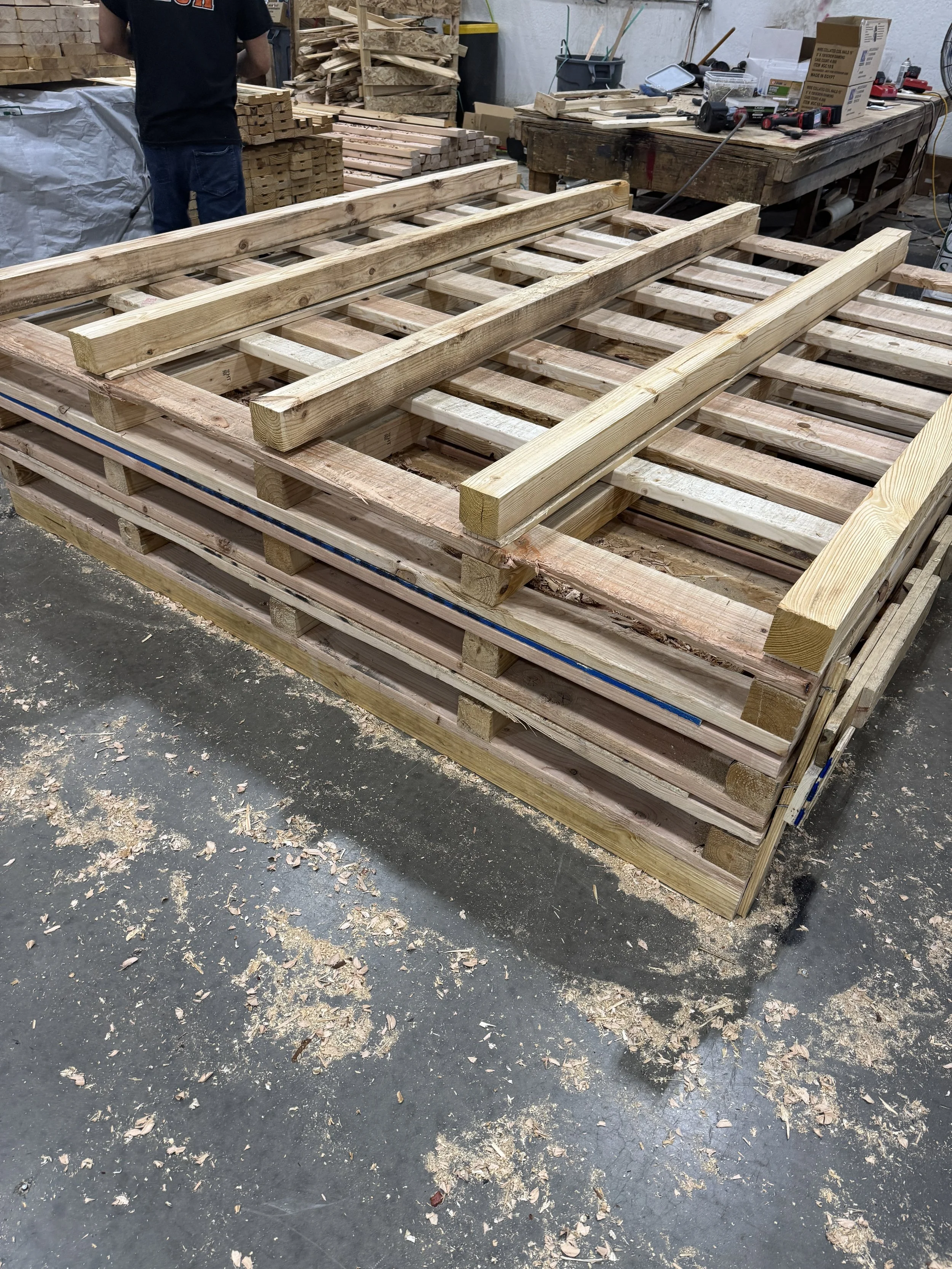

Close-up of the reinforced runners on an Atlas 104 by 96 inch heavy-duty pallet
Close-up of an ISPM-15 IPPC heat treatment stamp on an Atlas export pallet

The numbers

In the first four months of the program, the build shipped more units than any other custom job in Atlas's history. The pallets do not just go out the door. They cycle back, get inspected, get repaired where needed, and go out again. The numbers below are units shipped, not unique pallet count.

1,274

Heavy-duty 104 by 96 pallets shipped since January 2026

21

Full truckloads delivered

486,668

Pounds of wood, total

2

Countries served, US and Mexico

The relationship

Atlas runs the deliveries on a pace the customer's install schedule sets. When the customer confirms an install date, Atlas times the build, the heat treatment, and the truck so the pallets get there on time.

Atlas runs lean by design. That structure is what keeps a program of this size accountable to a single point of contact. The customer does not have to chase Atlas. Atlas initiates to stay on top of the project.

The result

The 104 by 96 returnable program is the single biggest custom build in Atlas's history. It started in January 2026 and the cadence has held wave after wave since.
